VIETNAM REAL ESTATE MARKET UPDATE
This page is made available solely for general informational purposes. Priority was given to official legal texts, Government News, Ministry of Construction, Vietnam News, Vietnam Investment Review, Reuters and selected legal analysis where the statutory text is not easily readable in English.
Laws, regulations, immigration frameworks, underwriting criteria and compliance obligations are subject to amendment, reinterpretation and jurisdiction specific variation without notice. Each investor should undertake their own independent review and consult separately with qualified legal counsel, tax advisers, immigration specialists, and properly authorized financial institutions before making, implementing or omitting any decision or course of action.
OFFICIAL Q1 2026 NEW COMMERCIAL APARTMENT LAUNCH NATIONWIDE
— Hanoi Capital City ~VND 128 million/m2 (~USD 4,904/m2).
— Ho Chi Minh City ~VND 112 million/m2 (~USD 4,291/m2).
— 58 projects were newly licensed for construction, with 31,816 units, up 232% QoQ and 223% YoY.
— 43 projects were approved for investment policy.
— 917 projects were under implementation, with ~500,384 units. 33 projects were completed, adding 5,838 units.
OFFICIAL Q1 2026 TRANSACTIONS NATIONWIDE
— 139,855 successful real estate transactions, equal to 92.4% of Q4 2025 and 103.9% of Q1 2025.
— Apartments and individual houses accounted for 30,857 transactions.
— Land plots were more active with 108,998 transactions.
GOVERNANCE, RULES AND MARKET PLUMBING
Government Resolution 180/NQ-CP sets a direct accountability rule.
Resolution 180/NQ-CP dated 6 July 2026 directs ministries, agencies and localities to translate second-half priorities into monthly and quarterly work, identify the lead body and responsible person, and publish results of implementation. It also directs coordinated fiscal and monetary management, credit toward productive sectors, public-investment acceleration and review of overlapping rules.
The Resolution records external volatility and domestic bottlenecks affecting macroeconomic stability, inflation, energy security, growth and major economic balances. (Source)
GOVERNANCE, RULES AND MARKET PLUMBING
Private corporate bonds: Decree 200 fixes issuer liability and amendment thresholds.
Decree 200/2026/NĐ-CP enacted from June 2026 regulates private corporate bond offerings and trading in Vietnam, and international offerings by Vietnamese issuers. The decree assigns disputes, complaints, use-of-proceeds performance and principal-and-interest repayment responsibility to the issuer.
Proceeds must be used for the disclosed purpose and tracked separately; green-bond proceeds must also be separately accounted for and used for qualifying green projects. (Source)
GOVERNANCE, RULES AND MARKET PLUMBING
FTSE reclassification is confirmed, phased and conditional at security level.
FTSE Russell confirms Vietnam’s reclassification from Frontier to Secondary Emerging status. Inclusion in FTSE GEIS begins in four tranches: 10% of investability weight in September 2026, 20% in March 2027, 35% in June 2027 and 35% in September 2027. The final September-2026 eligible security list is scheduled for 21 August 2026.
Securities are screened for liquidity, minimum size and foreign headroom. FTSE will evaluate index trackers’ ability to replicate benchmark changes after each tranche before proceeding. A partly included security that later fails retention eligibility will be deleted under the standard methodology and its remaining scheduled tranches will not be implemented. (Source)
GOVERNANCE, RULES AND MARKET PLUMBING
Vietnam’s domestic carbon exchange begins formal operation.
The Ministry of Agriculture and Environment reported the formal launch of the domestic carbon exchange on 29 June 2026. Tradable instruments comprise greenhouse-gas emission allowances and carbon credits, using existing securities-market infrastructure. The official release distinguishes allowances allocated in advance from verified emission reductions or removals represented by carbon credits. Entities exceeding allocated emissions must acquire additional allowances or use credits in accordance with the rules. (Source)
GOVERNANCE, RULES AND MARKET PLUMBING
International Financial Centre receives a unified governing council.
The Prime Minister approved the governing council for Vietnam’s International Financial Centre on 6 July 2026. The council directs and coordinates the Centre’s construction, operation and development and issues strategy, roadmaps and development plans for the Ho Chi Minh City and Da Nang locations. Policy for the Centre must be unified, concentrated and continuous, while preserving independence, professionalism, transparency, safety, efficiency and alignment with international practice. The Ministry of Finance is directed to design and propose mechanisms and products and to escalate difficulties promptly. (Source)
GOVERNANCE, RULES AND MARKET PLUMBING
Resolution 10-NQ/TW replaces volume-focused FDI selection with performance tests.
Resolution 10-NQ/TW dated 8 June 2026 establishes the policy framework for foreign-invested economic development. It records excessive shares of labor-, resource-, land- and energy-intensive projects, assembly activity, low localization and domestic value added, weak domestic-enterprise linkages and limited technology transfer.
Quality, efficiency, technology transfer, supply chain participation and value added are the principal criteria. Support is to shift from input-based incentives to support tied to delivery of commitments across the project life cycle. Authorities are directed to monitor commitments and may recover incentives or apply other measures where commitments are not met, land, resources or energy are wasted, or environmental and social harm occurs. (Source)
GOVERNANCE, RULES AND MARKET PLUMBING
Vietnam-EFTA negotiations conclude; the reported status stops at conclusion.
Vietnam and the European Free Trade Association concluded negotiations on a comprehensive free-trade agreement on 2 July 2026. The announced scope includes trade in goods and services, rules of origin, sanitary and phytosanitary measures, technical barriers, investment, intellectual property, trade remedies, government procurement, sustainable development, SMEs and capacity building.
The parties state that the agreement is intended to reduce or remove duties, facilitate trade and promote sustainable development. Both cited releases report conclusion of negotiations. (Source)
CAPITAL, DEMAND, CREDIT AND MARKET CYCLE
H1 2026 output is strong; the Government retains macro-stability controls.
The National Statistics Office reported real GDP growth of 8.18% in the first half of 2026, including 8.39% in the second quarter. The State Bank reported average first-half CPI growth of 4.38%. Resolution 180/NQ-CP records continued pressure from external volatility, extreme weather, energy-security risks and domestic bottlenecks.
The Government directs macroeconomic stability, inflation control and protection of major economic balances while pursuing growth of at least 10% for 2026. Ministries, sectors and localities are instructed to update growth scenarios rather than rely on the original plan. (Source)
CAPITAL, DEMAND, CREDIT AND MARKET CYCLE
Credit allocation remains focused on productive sector, with explicit risk controls.
Approximately 77% of economic credit served production and business. Agriculture and rural sectors represented 22.09% of outstanding credit and SMEs 19.84%; export credit grew 20.53% and credit to high-technology-applying enterprises grew 26.36%.
The State Bank of Vietnam identifies non-performing loans, risk-prone credit segments, weak institutions, cyber risk and continuity of banking information systems as matters requiring continued control. Banks are directed to grow credit safely and effectively, reduce operating costs to create room for lower lending rates, strengthen financial capacity, control and resolve non-performing loans, and control credit into potentially risky sectors. Restructuring of weak and specially controlled institutions remains an assigned task. (Source)
CAPITAL, DEMAND, CREDIT AND MARKET CYCLE
Imports outpace exports; origin and market-diversification controls tighten.
Goods exports reached US$266.52 billion in H1 2026, up 21.0% year on year. Goods imports reached US$283.17 billion, up 33.4%. Resolution 180/NQ-CP directs diversification of export markets, products and supply chains; more comprehensive use of signed FTAs; early warning support for trade remedies; traceability and green standard compliance; and stronger action against origin fraud, smuggling, counterfeit and substandard goods. (Source)
CAPITAL, DEMAND, CREDIT AND MARKET CYCLE
Social housing has moved from slogan to operating program.
More than 103,000 social housing units were completed in 2025. The 2026 target is 158,723 units, within a 2026-2030 allocation of 973,471 units nationwide. Ho Chi Minh City has the largest quota through 2030 at 181,257 units. Labor housing stabilizes industrial occupancy, commute patterns, and local consumption around industrial and logistics assets. (Source)
CAPITAL, DEMAND, CREDIT AND MARKET CYCLE
Foreign-investment commitments rise; realized capital remains the operating measure.
Total registered foreign investment reached US$34.65 billion, up 61.0% year on year. Realized foreign direct investment was approximately US$13.03 billion, up 11.2%. Resolution 10-NQ/TW rejects quantity as the primary quality test and records weaknesses in localization, value added, technology transfer and domestic-enterprise linkages. It requires monitoring of investor commitments and permits recovery of incentives or other action where commitments are not performed. (Source)
CAPITAL, DEMAND, CREDIT AND MARKET CYCLE
National public-investment disbursement reaches 35.8%; performance scoring becomes allocative.
Public investment disbursement reached VND360,948.7 billion, equal to 35.8% of the VND1,008,034.2 billion plan assigned by the Prime Minister. 25 central ministries or agencies and 11 localities were below the national average. The official update identifies material dispersion in implementation performance across spending entities and localities.
Resolution 180/NQ-CP requires monthly pilot scoring of disbursement performance, formal implementation from October 2026 and use of the score as a basis for future public-capital allocation. The stated objective is 100% plan disbursement, alongside resolution of long-stalled projects within legal authority. (Source)
CAPITAL, DEMAND, CREDIT AND MARKET CYCLE
Ho Chi Minh City: slow projects are to be published and leadership responsibility attached.
Ho Chi Minh City recorded 8.55% GRDP growth, public-investment disbursement of 34.9% of the Prime Minister-assigned plan and nearly US$7.5 billion of FDI in H1 2026. The conclusion records that growth was below the city’s 10.04% scenario and disbursement ranked 24th of 34 localities. The official conclusion records projects with zero or very low disbursement, slow key projects, land clearance difficulties, weak coordination and continued shifting or avoidance of responsibility.
The City is required to prepare weekly, monthly and quarterly disbursement scenarios; publish delayed projects and works; attach the head of the unit’s responsibility to disbursement results; review projects with large capital allocations but no or very low disbursement; and prevent projects from waiting for land handover. (Source)
CAPITAL, DEMAND, CREDIT AND MARKET CYCLE
Government-bond issuance reaches VND182.561 trillion in H1 2026.
The State Treasury raised VND182.561 trillion through government bonds, equal to 37% of the annual plan. Issuance was concentrated in 10-year and 5-year tenors, representing 58% and 39% respectively. Auctions were successful across 3-, 5-, 10-, 15- and 30-year tenors.
The release reports end-June yields of 3.52% for 3 years, 4.18% for 5 years, 4.35% for 10 years, 4.40% for 15 years and 4.58% for 30 years. It does not state a separate negotiation mandate or discretionary concession policy. (Source)
CORRIDORS AND OPERATING PLATFORMS

Long Thanh Airport: commercial opening remains conditional on integrated testing and safety certification.
ACV reported 77% of signed contract value completed and approximately 70% for essential airport works by end of June 2026. Passenger-terminal technical readiness is targeted for September 2026; integrated trial operation is scheduled for September; commercial operation is targeted for December 2026.
ACV recorded a shortage of approximately 1,668 personnel and more than 20,000 outstanding drawings. Material-price increases and wet-season delay risks were also recorded. Commercial operation follows trial results and issuance of operating-safety certificates under the rules. ACV formally committed to complete all 13 main construction packages and provide infrastructure sufficient for safe commercial operation in December 2026. (Source)
CORRIDORS AND OPERATING PLATFORMS
Long Thanh access and airport systems must complete as one operating chain.
The Government’s project conclusion retains the 2026 commercial operation target for Long Thanh and directs acceleration of the Ho Chi Minh City-Long Thanh-Dau Giay expressway expansion. The cited conclusion reports a 2026 completion objective for the expressway project and a Q1 2027 target for the Long Thanh bridge component.
All project owners and contractors are directed to mobilize maximum equipment, personnel and resources, complete components synchronously, control installation quality, conduct prescribed trial operations and preserve absolute safety. The source states that the 2026 airport target is unchanged and mandatory. (Source)
CORRIDORS AND OPERATING PLATFORMS

Can Gio transshipment port approval carries capital, lock-up and delivery conditions.
Ho Chi Minh City approved the investor consortium comprising VIMC, Saigon Port and Terminal Investment Limited Holding for the Can Gio International Transshipment Port. The project is approximately 571 hectares, with stated capacity of 4.8 million TEU by 2030 and 16.9 million TEU by 2047, a reported investment of about VND128.872 trillion and a 50-year operating term.
The approved investor must demonstrate financial capacity and self-balance funding; project transfer is restricted for 10 years from land and sea-area handover; at least VND50 trillion is to be disbursed in the first 10 years; and the full project is to be completed within 20 years. The Government’s stated threshold is investment only when national-interest requirements are met, including defined objectives, operating conditions, carrier participation, domestic-enterprise cooperation and volume commitments. (Source)
CORRIDORS AND OPERATING PLATFORMS

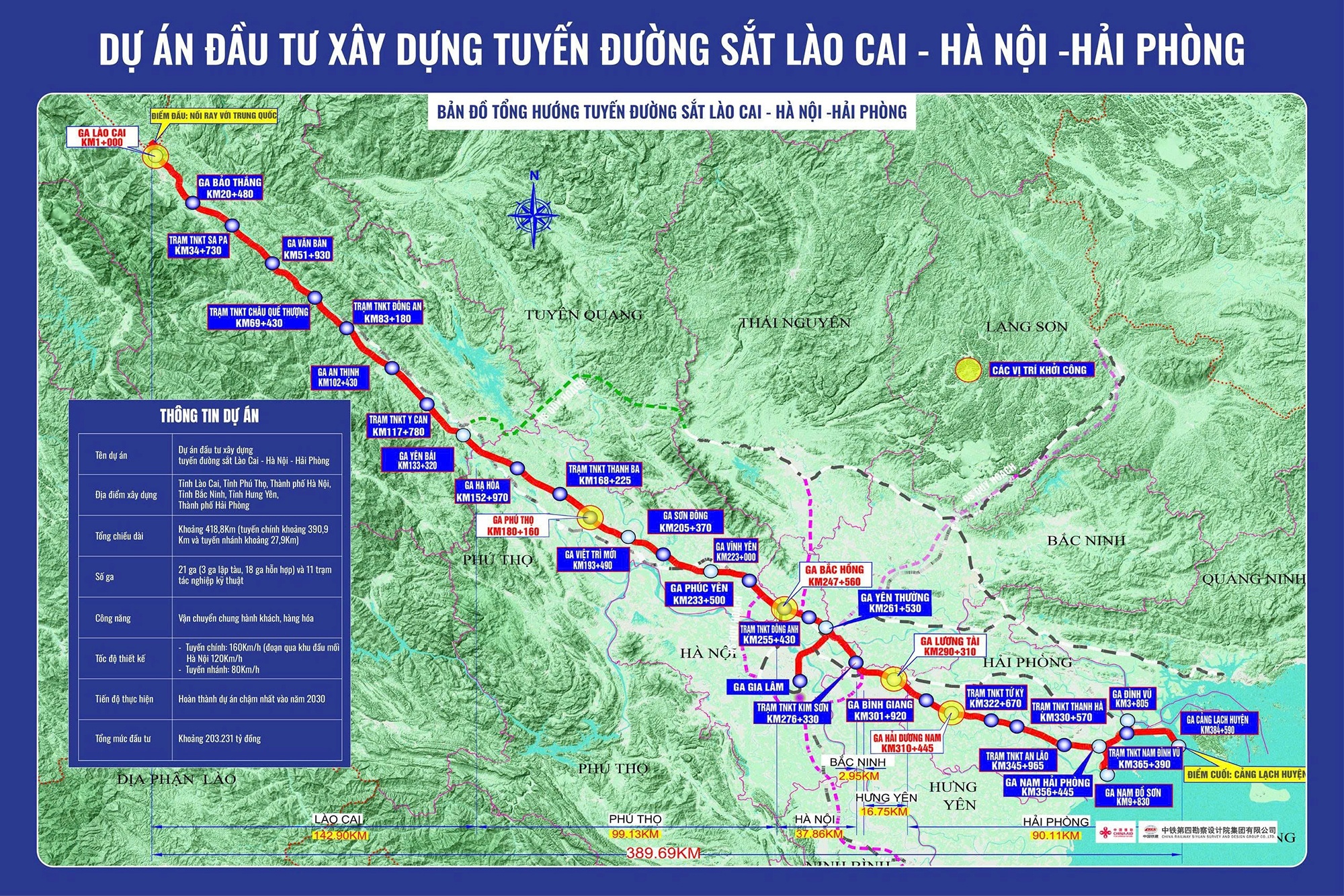

Lao Cai-Hanoi-Hai Phong railway: schedule cannot override technical process.
The Government directed synchronized land clearance along the line and early resolution of investment-policy and alignment issues for the Lao Cai-Hanoi-Hai Phong railway. Workforce preparation for system reception, operation and maintenance is also required.
The stated line is unambiguous: preserve the schedule while strictly complying with technical procedures; do not pursue schedule at the expense of technical risk. The direction also requires early, decisive treatment of investment-policy and alignment issues and early training of operating and maintenance personnel. (Source)
CORRIDORS AND OPERATING PLATFORMS
Power Development Plan VIII review requires high feasibility for new projects.
The Ministry of Industry and Trade requested provinces and cities to provide data for review and update of the adjusted Power Development Plan VIII. Localities must review projects already in the plan and identify power source and grid needs.
The review addresses implementation obstacles and the need to align generation and transmission planning with energy-security and development requirements. New power-source and grid projects are to be proposed for possible inclusion only when they have high feasibility. The Ministry requires local data and project review as the basis for the plan update. (Source)
CORRIDORS AND OPERATING PLATFORMS
Digital-economy program defines infrastructure as secure, trusted and energy efficient.
The 2026-2030 digital-economy program prioritizes broadband, 5G and next-generation mobile networks, low-earth-orbit satellite services, data centers, cloud computing, high-performance computing and AI infrastructure supplied as services. Infrastructure is to be reliable, safe and secure, with green and energy efficient data center and computing development. The program also directs interoperable national and sectoral data infrastructure and stronger protection of networks, data and information systems. (Source)
CORRIDORS AND OPERATING PLATFORMS
Strategic technology-enterprise status is tied to measurable scale and R&D thresholds.
The program targets at least 10 large strategic-technology enterprises by 2030. It also targets six new submarine cable systems, including one Vietnamese-owned system; 5G coverage of 99% of the population; and five new large, green, international-standard data centers. A large strategic-technology enterprise is expected to have annual revenue of at least US$1 billion, at least 5,000 employees participating in social insurance, R&D spending of at least 3% of revenue and at least one recognized patent. The program also targets domestic mastery of 70% of listed strategic technologies. (Source)
